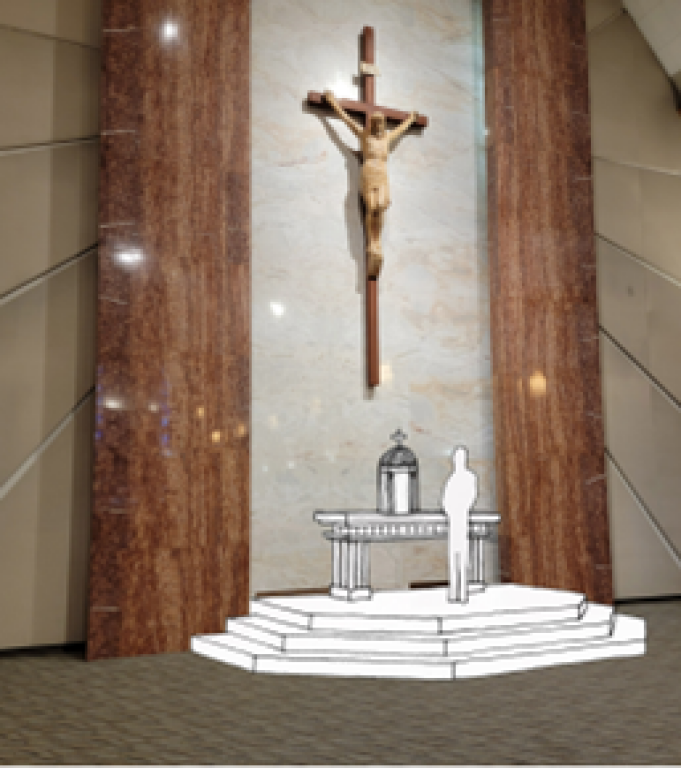

Altar of Repose Construction
We are thrilled to announce that we will be undertaking a new project that will bring the Real Presence of Jesus more literally into the center of our church! A new altar of repose and new tabernacle to house the Blessed Sacrament will be installed in the space under the main crucifix in the sanctuary. The altar of repose will be built out of wood from the large maple tree that was removed last Spring, and the tabernacle is being repurposed from another worship space; we are pleased that we will undertake this project as responsible stewards of our resources by re-using materials in this way. Construction will begin in January and will be completed before Easter.
We would like to thank the Bruning family, whose generous donations in memory of their mother will make this holy project possible.
Click image to see more!
Construction Timelapse Video
Watch our building come to life!
August-September 2023
Clearing and grading the site, placing foundation footings and plumbing.
Project Timeline
2017: Visioning a Future for Queen of the Holy Rosary
DO YOU RECALL how and when this all began? In early 2017, Fr. Bill along with the Parish Council, established six Goals for the Parish to review. In July 2017, a Visioning Process began which involved more than 50 parishioners, so many of you participated. The Six Goals evolved into 10 Visioning Teams, one of which was Facilities.
The Facilities Visioning Team was charged with reviewing the current facility needs of the parish as well as future needs that may come from the other teams. In December 2017, the Visioning Process was completed with all teams reporting to the Visioning Team Executive Committee.
November, 2017: Key Insights of the Facilities Visioning Team:
- The campus needs space for multiple meeting groups of 30-50 people, ADA compliant and with corresponding AV technology. There is only one existing space that partially meets those requirements, the Parish Hall. QHR has over 30 ministries which require meeting space on some frequency and many are weekly. Conflicts for reserving space occur often.
- The Convent and Church Office lack ADA compliance, security and modern heat and A/C. Therefore, they are very much underutilized. It was determined that it was not cost effective to upgrade these buildings. Also, they are not very welcoming for visitors.
- To follow our Mission Statement to be more hospitable, the Narthex of the church needs to be enlarged to the east.
2018-2019: The Fiat for the Future Capital Campaign Begins
April 1, 2018: The Visioning Team Executive Committee gave a report in the Sunday bulletin of forward action required of the ten Visioning Teams, called the Strategic Pastoral Plan. Throughout the remainder of 2018, they established that the best way to achieve the needs established by the Visioning Facilities Team was a capital improvement project. Consequently, the Fiat Center Project was born.

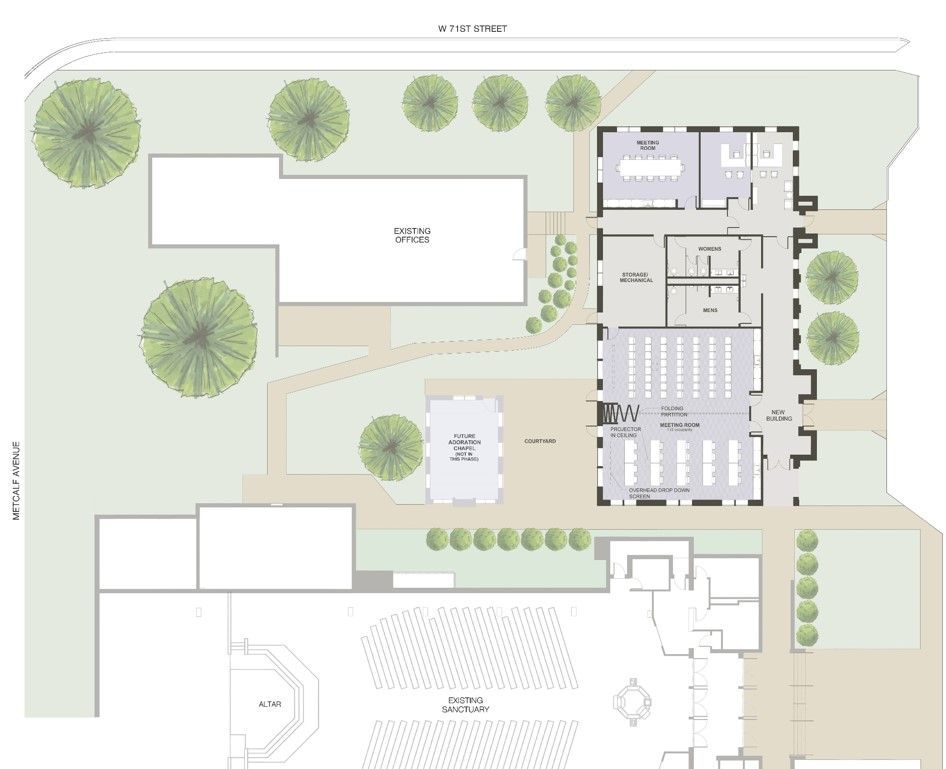

Throughout 2018 and into 2019, the Facilities Visioning Team continued work on developing a capital improvement project for a new L-shaped building. The project included demo of the existing office building, extending the Narthex east and a covered connection from the church to the new building. Preliminary plans were developed and costs were estimated at $4,000,000. This did not include the Archdiocese One Faith, One Future Capital Campaign, which had assessed Queen for $1,100,000.
Throughout 2019, a capital fundraising campaign was developed with the assistance of a consultant. Fr. Bill mailed out letters with pledge cards and information presentations were held in the church after all Masses and in the Parish Hall to explain the project.
2020-2021: Re-evaluating the Project after the Pandemic
March, 2020: COVID. The campaign continued even though the church was closed. Pledges received were $2,600,000 and the amount collected was $795,000 from 498 families. Project planning continued, but slowed. Construction costs increased significantly due to COVID shutdowns and restrictions.
August, 2021: It was determined that the campaign could not support the original project due to rising construction costs. The church office (Rectory) would stay, the Narthex would not be extended and the covered walkway between the church and the new building would not be built at this time. The Fiat Center would be smaller, but would still accommodate the majority of the parish needs.
2022: Our Commitment to One Faith, One Future
Early 2022: The Parish Finance Committee decided to pay off the Archdiocese’s One Faith Campaign in the amount of $1,035,000. Because we had available funds, we were able to make one payment which gave us a discount from the original assessed amount of $1,100,000. All parishes had to pay a predetermined assessment, but we were able to benefit because we had our own concurrent capital campaign.

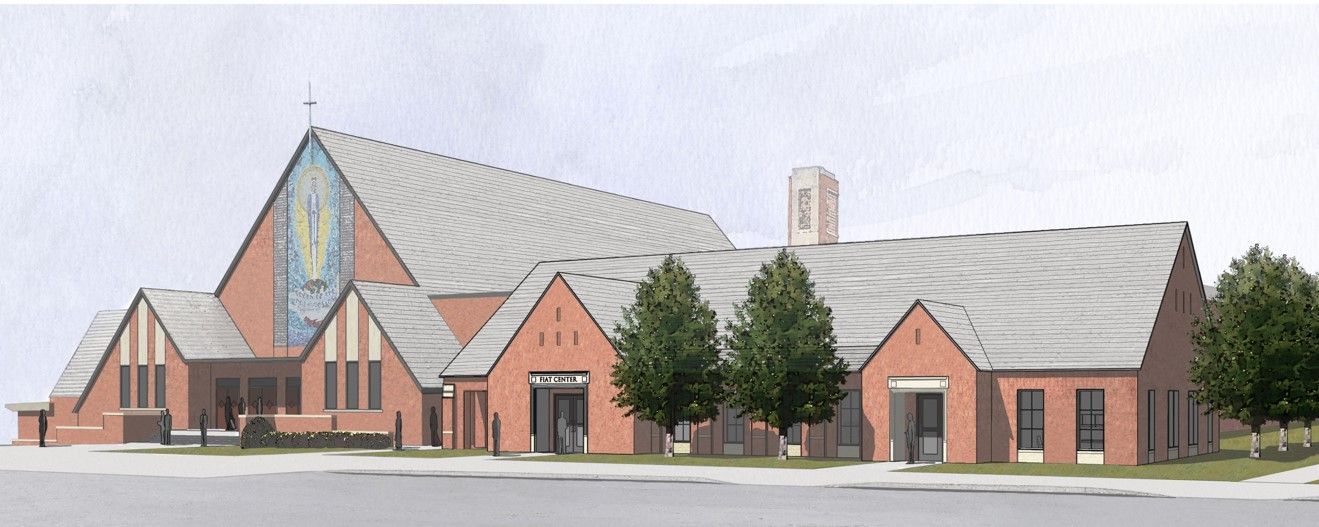

2022: Building for the Future
April 24, 2022: Fr. Bill sent out a 2nd campaign letter with all the details, mainly the church office will stay, the Narthex will not be extended at this time and the new building will be smaller. The revised project cost is estimated at $2,750,000 rather than $4,000,000. The letter asked for additional pledges for the current shortfall of approximately $1,263,000.
July, 2022: (Behind the scenes work) Site soil borings and geotechnical report completed.
August, 2022: The Fiat Oversight Committee was established from members of the Facilities Visioning Team. They are Ralph Pruente, Austin Massoth and C.J. Pfieffer. They represent the professions of Construction Project Management, Building Construction, Architecture, and Facilities Maintenance. They report to Fr. Bill. Queen is fortunate to have them.
Revisiting the WHY
WHY are we building for the future?
- Need more meeting rooms for the 30 plus ministries
- Accommodate special events for the school
- Make office more accessible and welcoming
- Provide for adult formation such as School of Faith
- Need ADA compliant space with latest AV capabilities
- Provide for future generations
How can you help?
- Are you or do you know a subcontractor or supplier?
- Do you own a business in AV equipment, blinds or other furnishings?
- Would you make a donation for naming rights to a room?
- Would you buy a window or supply art?
- Do you have woodworking skills with wood from the Silver Maple?
- Could you supply courtyard furnishings?
For questions or comments, contact Ralph Pruente, rpruente@sbcglobal.net
Fall 2022: Gaining Momentum

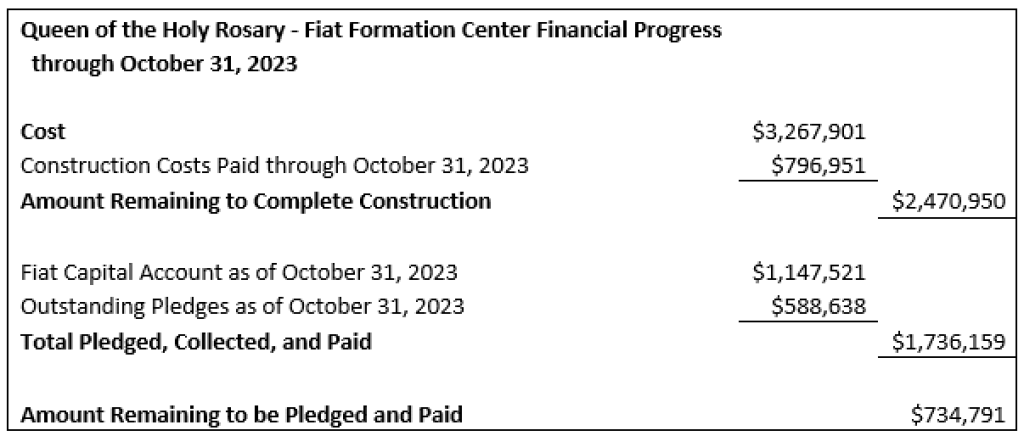

September 30, 2022: Latest financial report establishes that after the 2nd Campaign pledges there is still a remaining shortfall amount of $341,500. Due to additional pledges, as reported in the December 4th bulletin, the shortfall amount is reduced to $319,000.
October, 2022. Site survey and property description completed.
November 15, 2022: Fr. Bill received notice that the Archdiocese had approved a loan to cover any cash shortfalls up to $1.4M with a 5 year term. This is assurance of available cash once the project is started. Receipt of future pledges should cover the payback.
December, 2022: Discussions of Preliminary and Final Development Plans with the Overland Park Planning Staff were completed.
December 2022: City Planning Approval
December 12, 2022: The Oversight Committee met with the Overland Park Planning Commission in a Public Hearing to review any public concerns and to review plans as required for obtaining city approval. The plans were approved with required stipulations as follows:
- Install four landscaped islands on the north and south sides of the parking lot between the school and Fiat Center. (taking up 8 parking spaces)
- Provide additional street trees adjacent to Metcalf Avenue and 71st
- All rooftop and ground mounted mechanical equipment must be screened from view.
- All existing public sidewalks must meet City standards of repair.
- All new sidewalks and ramps must meet current City standards.
- All preliminary and final plats must be completed.
- All driveways and parking areas are subject to review.
The Last Six Months: A Flurry of Activity Gets Construction Underway!
December 14, 2022: The Oversight Committee met with four General Contractors on campus to review the site and answer any questions before bidding on Preconstruction Services. The four contractors were A.L. Huber, Rau, KBS and Straub. They all have experience in church building construction projects.
December 21, 2022: Bids were due in the office by 5:00 pm.
January 3, 2023: The Oversight Committee met with Fr. Bill to review the bids on criteria such as cost, trust, Company age, proposal presentation, transparency, integrity, management systems, Kansas Catholic experience and overall comfort level by the Oversight Committee.
Straub Construction was selected to provide Preconstruction Services starting immediately in preparation for the actual construction in midyear. These services include providing pricing, overall project scheduling, construction logistics, assist in actual construction bidding, subcontractor selection, cost control, reviewing alternatives with the architect and Oversight Committee and more as needed.
January 4, 2023: Dan Himmelberg, Director of Real Estate & Construction for the Diocese, was notified about Straub being selected to perform preconstruction services.
January 17: The Fiat Oversight Committee (FOC) met with Straub and BBN Architects for resolution of such items as:
• Identifying long lead time materials
• Research value engineering of steel vs wood framing (wood is ideal for this building type)
• Locate exterior materials to match the church and other buildings on campus
• Estimate duration of construction and identify delays to avoid
• Assist architect in pricing and suggest cost saving alternatives
• Assist architect in information required to obtain City Permits
• Review interior materials and AV equipment
• Access all utilities to determine underground locations
February, 2023: A formal contract between the Diocese and Straub has been drafted by Straub. BBN Architects are to issue a new set of plans by mid-month. After time to review, Straub will submit a Guaranteed Maximum Price for their work and a final formal contract will be signed by both parties. Other February activities:
• Work continues to locate all existing utilities.
• An existing conduit from the office to the school will have to be rerouted or eliminated.
• BBN is working with the surveyor to plat the entire campus as required by the city before a building permit will be issued.
• No plans have been made for the Silver Maple tree other than to save some of the larger limbs.
• A revised construction cost estimate by the contractor is due March 9. A date for final architectural drawings has not been set.
May 4, 2023: BBN Architects to complete final drawings.
May 8, 2023: BBN meets with OP Codes Department to begin building permit process, which could take 4-6 weeks. Straub sends drawings to sub-contractors for bidding.
May 17, 2023: Payment due for city excise tax.
May 23, 2023: Sub-Contractor bids due back to Straub.
May 30, 2023: Sub-Contractors are chosen.
June 10, 2023: Ground breaking!
June 12, 2023: Four trees will be removed for the Fiat Center as well as a large Spruce west of the church.
July 10, 2023: Projected construction start date.
What about those trees?
1. Silver Maple (the large one): Some remember it as a mature tree (maybe 25 years old) in 1961 when the church was built. At over 80 years old, it is apparently healthy but is past its normal life span of 50-60 years. It may be rotten and hollow inside. It is a soft Maple and is subject to damage from heavy branch loads of snow and high wind. Some of the wood may be sold or made into craft or landscape items. A Kansas City company has been contracted to create an artistic timeline of the history of the parish out of a slice of the tree trunk, as well as a conference table from the wood.
2. Sugar Maple (medium size north of Silver Maple): This tree is estimated to be 40 years old, appears to have sustained lightning damage and is declining in health.
3. Dogwood (east of the office at the upper elevation): This tree is estimated to be 30 years old, is healthy, but will need to be removed as it is at the west wall of the new building.
4. A smaller Silver Maple: This tree just west of the office parking lot will also need to be removed because it is at the west wall of the new building. It could have been planted about the same time as the Sugar Maple.
For questions or comments, contact Ralph Pruente, 913-707-9589, rpruente@sbcglobal.net
